BOARD MEETING DATE: May 19, 2000 AGENDA NO. 26




REPORT:

Rule and Control Measure Forecast

SYNOPSIS:

This report highlights AQMD rulemaking activity for the year 2000. Upcoming public workshops are also noted in the report.

COMMITTEE:

Stationary Source, April 28, 2000, Reviewed

RECOMMENDED ACTION:

Receive and file.

Barry R. Wallerstein, D.Env.
Executive Officer


The Rule and Control Measure Forecast Report provides the Board with a monthly update of AQMD’s rulemaking and control measure implementation schedule. Scheduling changes which occurred since last month’s forecast are summarized. There may have been changes to this report since review by the Stationary Source Committee.

In this month's report, the status of the 1999 SIP's implementation is also summarized. The 1999 SIP commits the AQMD to adopt and implement control measures to achieve VOC reductions by specified timeframes as well as to consider a list of control measures identified in the SIP. Figures 1 and 2 illustrate the reductions to be achieved by rules adopted as of April this year.

As can be seen, creditable SIP reductions from amended Rule 1150.1 - Control of Gaseous Emissions from Municipal Sold Waste Landfills, Rule 461 - Gasoline Transfer and Dispensing in February and April 2000, and Rule 1130 - Graphic Arts from last year, combined achieve approximately 90% of the emission reduction commitment for the year 2000. In addition, the implementation schedule adopted is significantly ahead of the time frame specified in the 1999 SIP projection. There are four remaining rules to be considered in this calendar year as required under the 1999 SIP:

PR1138 - Restaurant Operations, PAR442 - Usage of Solvents, PAR1168 - Emission Reductions from Adhesives, and PR1132 - Emission Reductions from Large Solvent and Coating Operations. It is thus anticipated that the SIP reduction target for this year will be met, if not exceeded.

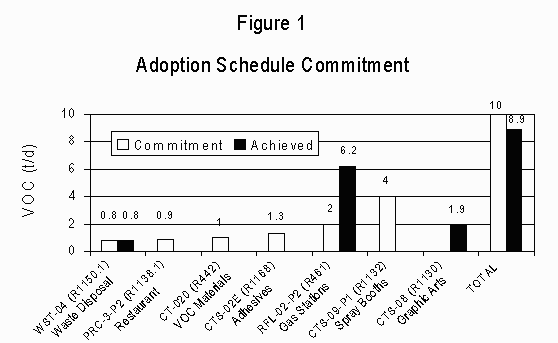

Figure 1 - Adoption Schedule Commitment

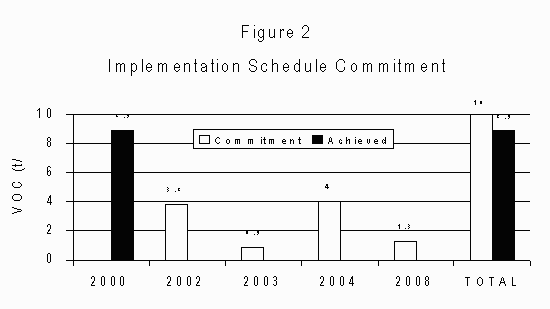

Figure 2 - Implementation Schedule Commitment

Rules to be Rescheduled/Removed and Added

Rule 1122 - Emissions Reductions from Degreasing Operations (CM#99 CTS-08, CM#99 ADV CLNG)

The proposed amendments are rescheduled from August to October in order to collect toxic emissions data and to determine/evaluate additional potential VOC reduction approaches. The proposed amendments include, among other methods, reducing the VOC content from 50 g/l to 25 g/l for cleaning materials in batch-loaded cold cleaners.

Rule 1146 - Emissions of Oxides of Nitrogen from Industrial Institutional and Commercial Boilers, Steam Generators, and Process Heaters

The proposed amended rule is added to June in order to address an issue with a variance in a timely manner. A separate amendment is scheduled for October to address CARB comments.

Rule 1186.1 - Alternative-Fuel Sweepers

Proposed Rule 1186.1 is being rescheduled from July to August so that additional comments from the PR 1186.1 Working Group can be incorporated into the rule language and supporting documentation. Proposed Rule 1186.1 would require that all newly purchased (owned, leased, or contracted for) sweepers used in government street sweeping be alternate-fuel sweepers.

Regulation XIII - New Source Review

Regulation XX - RECLAIMs

These amendments are being rescheduled from July to August to allow additional public input for the environmental assessment. The proposed amendments will separate Best Available Control Technology (BACT) into Lowest Achievable Emissions Rate (LAER) for federal major sources and state BACT for minor sources.

Rule 1401 - New Source Review of Toxic Air Contaminants

The proposed amended rule is scheduled for August. The state recently finalized new or revised chronic risk factors for toxic air contaminants. This report will analyze potential impacts from these changes and make recommendations relative to using new risk values for Rules 1401 and 1402.

Rule 1402 - Control of Toxic Air Contaminants from Existing Sources

The proposed amended rule is scheduled for August. The state recently finalized new or revised chronic risk factors for toxic air contaminants. This report will analyze potential impacts from these changes and make recommendations relative to using new risk values for Rules 1401 and 1402.



RULE AND CONTROL MEASURE FORECAST REPORT - MAY 2000

MASTER CALENDAR
Advance Target for Board Hearings

Below is a list of all rulemaking activity scheduled for the year 2000. The last three columns refer to the type of rule adoption or amendment: AQMP refers to the adoption and implementation of AQMP control measures (Attachment A); Toxics refers to the adoption and implementation of programmatic as well as source specific toxic related rules (Attachment B); and Other refers to administrative rules or changes to an existing rule to clarify or improve rule enforceability, SIP corrections, or implementing state or federal regulations (Attachment C). A more detailed description of the proposed rule adoption or amendment is located after this calendar under the type of rule adoption or amendment (i.e. AQMP, Toxics, and Other) Upcoming Public Workshops are located at the end of the report (Attachment D).

*An asterisk indicates that the rulemaking is a potentially significant hearing.
+This proposed rule will reduce criteria air contaminants and assist toward attainment
of ambient air quality standards.
MAY


AQMP

TOXICS

OTHER

216

Appeals



219

Equipment Not Requiring a Written Permit Pursuant to Reg. II



222

Filing Requirements for Non-Permitted Equipment



Reg. III

Fees



JUNE


403.1

Wind Entrainment of Fugitive Dust



1146

Emissions of Oxides of Nitrogen from Industrial Institutional and Commercial Boilers, Steam Generators, and Process heaters



1191*, +

Clean On-Road Light- and Medium-Duty Public Fleet Vehicles



1192*, +

Clean On-Road Transit Buses



1193*, +

Clean On-Road Residential and Commercial Refuse Collection Vehicles



1610

Old Vehicle Scrapping



JULY


1194*, +

Commercial Airport Ground Access


AUGUST

AQMP
TOXICS
OTHER

109.1

and

Regulation XI

Alternative Recordkeeping. Also, for Regulation XI Rules this proposal will implement the recommendation of the Monitoring, Recordkeeping, and Reporting Task Force to streamline VOC recordkeeping.



431.2*, +

Sulfur Content of Liquid Fuels



1102

Petroleum Solvent Dry Cleaners



1103

Pharmaceuticals and Cosmetics Manufacturing Operations



1186.1*, +

Alternative-Fuel Sweepers



1195*, +

Clean On-Road School Buses



1196*, +

Clean On-Road Heavy-Duty Public Fleet Vehicles



Reg. XIII

and

Reg. XX

Regulation XIII - New Source Review (NSR)

RECLAIM



1401

New Source Review of Toxic Air Contaminants





1402

Control of Toxic Air Contaminants from Existing Sources




SEPTEMBER


442

Usage of Solvents (CM#99CTS-02O)



1131

(Formerly Rule 1194)

Food Manufacturing and Processing Operations (CM#99CTS-02O, CM#99PRC-06)



1168*

Emission Reductions from Adhesives (CM#99CTS-02E)


OCTOBER


1122

Emission Reductions from Degreasing Operations (CM#99CTS-08, CM#99-ADV CLNG)


OCTOBER
(continued)
AQMP
TOXICS
OTHER

1132*

Emission Reductions from Large Solvent and Coating Operations (CM#99CTS-09)



1138.1*

Control of Emissions from Underfired Charbroiler Restaurant Operations (CM#99PRC-03, Phase II)



1146

Emissions of Oxides of Nitrogen from Industrial Institutional and Commercial Boilers, Steam Generators, and Process heaters



1166

Volatile Organic Compound Emissions from Decontamination of Soil



NOVEMBER


1137*

(Formerly
Rule 1191)

Emission Reductions from Woodworking Operations (PM10) (CM#97PRC-01)



1425

Motion Picture Film Labs




DECEMBER


201

Permit to Construct



1105.1*

Fluid Catalytic Cracking Units (CM#97CMB-09)



2202

On-Road Motor Vehicle Mitigation Options



TO-BE-DETERMINED


Reg. IV, XI and

XIV Rules

Various rule amendments needed to achieve AQMP emission reduction requirements and other requirements of state and federal law. Also, various XIV rules will be evaluated for possible command-and-control rules to reduce toxic emissions as part of the Air Toxics Control Plan (ATCP) (these are listed in Attachment B).

518.2

Federal Alternative Operating Conditions



TO-BE-DETERMINED
(continued)
AQMP
TOXICS
OTHER

1110.2

Emissions from Gaseous and Liquid Fueled internal Combustion Engines



Reg. XVI

Mobile Source Credit Programs (CM#99 FLX-01)



1624

Credits for Clean Pleasure Craft Engines (CM#97MOF-07)



Reg. XX

RECLAIM



Reg. XXV*

Intercredit Trading (CM#99FLX-01)


2001


1133*

(Formerly Rule 1193)

Emission Reductions from Composting Operations (CM#99WST-02)



1173.1*

Fugitive Emissions from Large Sources of Volatile Organic Compounds (CM#97FUG-04 and CM #99 FUG-05)



1405

Control of Ethylene Oxide & CFC Emissions from Sterilization or Fumigation Processes





1421

Control of Perchloroethylene Emissions from Dry Cleaning Systems





1426

Metal Finishing





1469

Hexavalent Chromium Emissions from Chrome Plating and Chrome Acid Anodizing Operations




2002


1427

Rubber Manufacturing





1437

Furniture Stripping Operations





Note:

AQMD may add control measures necessary to satisfy federal requirements, to abate a substantial endangerment to public health or welfare, state regulatory requirements or SIP commitment.

Attachments

/ / /
